Public Works

Highlands Ranch Neighborhood Construction Projects

Roadway

Project Manager

Keith Burke, Inspector
[email protected]

303-947-8720

Contractor

Chato's Concrete, LLC

720-252-7959

Project Update

Sidewalk Repairs

Thistle Ridge Area (Venneford Ranch Rd. & Thistle Ridge Cir.)

August 10 – August 16, 2022 *:

Jimson Weed Way, Arrow Grass Way, Thistle Ridge Cir.

Stonebury Area (Wildcat Reserve Pkwy & Pennington St.)

August 16 – August 26, 2022*:

Pennington St., Ridgemont Cir., Ridgemont Pl., Graland Pl., Graland Ln.

Southpark Area (Northeast Corner of Broadway and Highlands Ranch Pkwy.)

August 25 – September 9, 2022*:

Woodland Dr., Saddlewood Cir., Rimrock Ct., Quail Ridge Cir., Hunters creek St., Timberline Pl., Larkspur Pl., Winrock St., Snowy Owl Pl., Mountain Cloud Cir., Round Rock St., Coyote St., Grouse Pl., Southpark Rd.



Asphalt Milling

Thistle Ridge Area (Venneford Ranch Rd. & Thistle Ridge Cir.)

August 29 – August 31, 2022*:

Jimson Weed Way, Arrow Grass Way, Thistle Ridge Cir.

Stonebury Area (Wildcat Reserve Pkwy & Pennington St.)

August 30 – September 1, 2022*:

Pennington St., Ridgemont Cir., Ridgemont Pl., Graland Pl., Graland Ln.

Southpark Area (Northeast Corner of Broadway and Highlands Ranch Pkwy.)

August 31 – September 9, 2022*:

Woodland Dr., Saddlewood Cir., Rimrock Ct., Quail Ridge Cir., Hunters creek St., Timberline Pl., Larkspur Pl., Winrock St., Snowy Owl Pl., Mountain Cloud Cir., Round Rock St., Coyote St., Grouse Pl., Southpark Rd.



Asphalt Paving

Thistle Ridge Area (Venneford Ranch Rd. & Thistle Ridge Cir.)

September 2 – September 7, 2022*:

Jimson Weed Way, Arrow Grass Way, Thistle Ridge Cir.

Stonebury Area (Wildcat Reserve Pkwy & Pennington St.)

September 5 – September 9, 2022*:

Pennington St., Ridgemont Cir., Ridgemont Pl., Graland Pl., Graland Ln.

Southpark Area (Northeast Corner of Broadway and Highlands Ranch Pkwy.)

September 8 – September 16, 2022*:

Woodland Dr., Saddlewood Cir., Rimrock Ct., Quail Ridge Cir., Hunters creek St., Timberline Pl., Larkspur Pl., Winrock St., Snowy Owl Pl., Mountain Cloud Cir., Round Rock St., Coyote St., Grouse Pl., Southpark Rd.



*All dates are subject to change

Description

The 2022 neighborhood street paving program in Highlands Ranch includes streets in the Northridge, Ranch Road, Thistle Ridge, and Kentley Hills areas. See the 2022 Neighborhood Street Paving Map for specific locations.

On each street, work will be done in three phases – the first phase consists of sidewalk repairs and curb ramp upgrades, which will be performed by the County’s sidewalk repair contractor Chato’s Concrete. Sidewalk repairs will begin after March 15 and will usually take between 2 and 4 weeks per neighborhood; work on a single block will generally take 3 to 4 days. The second phase will take place later in the summer and consists of rotomilling to remove some of the top layer of asphalt, which generally takes 2 to 4 hours or less per block to complete. The final phase follows rotomilling by 1 to 2 weeks and includes placing the new overlay; this last phase may take 4 – 8 hours to complete.

During construction, access to driveways is allowed, with occasional short delays. If the sidewalk contractor needs to replace the walk in front of your driveway, they will notify you so you can move your vehicles before the work is done.

1 to 2 weeks before the start of sidewalk repairs, the County will send Cone Zone Mailers to notify adjacent residents of the planned work. Cone Zone Mailers will also be sent 1 to 2 weeks before the start of rotomilling.

1 to 2 days before the start of each phase of work, the Contractor will deliver a Cone Zone door hanger with the date of the start of that phase of work on your block.

Two days before the start of rotomilling and paving, no-parking signs will be posted along the streets scheduled for work. Construction will be done Monday through Friday between 7 a.m. – 7 p.m.

Sidewalk Contractor
Chato’s Concrete, LLC
Phone: 720-252-7959

Asphalt Pavement Contractor
Martin Marietta Materials, Inc.

NOTE:  If your vehicle was towed because it was left in the construction zone, please contact Westside Towing at 303-688-5244 for information on where your car was towed.

Schedule

Sidewalk work will be scheduled between March and August. Rotomilling and paving will be scheduled between August and October.

Project Manager
Keith Burke, Inspector
[email protected]
303-947-8720

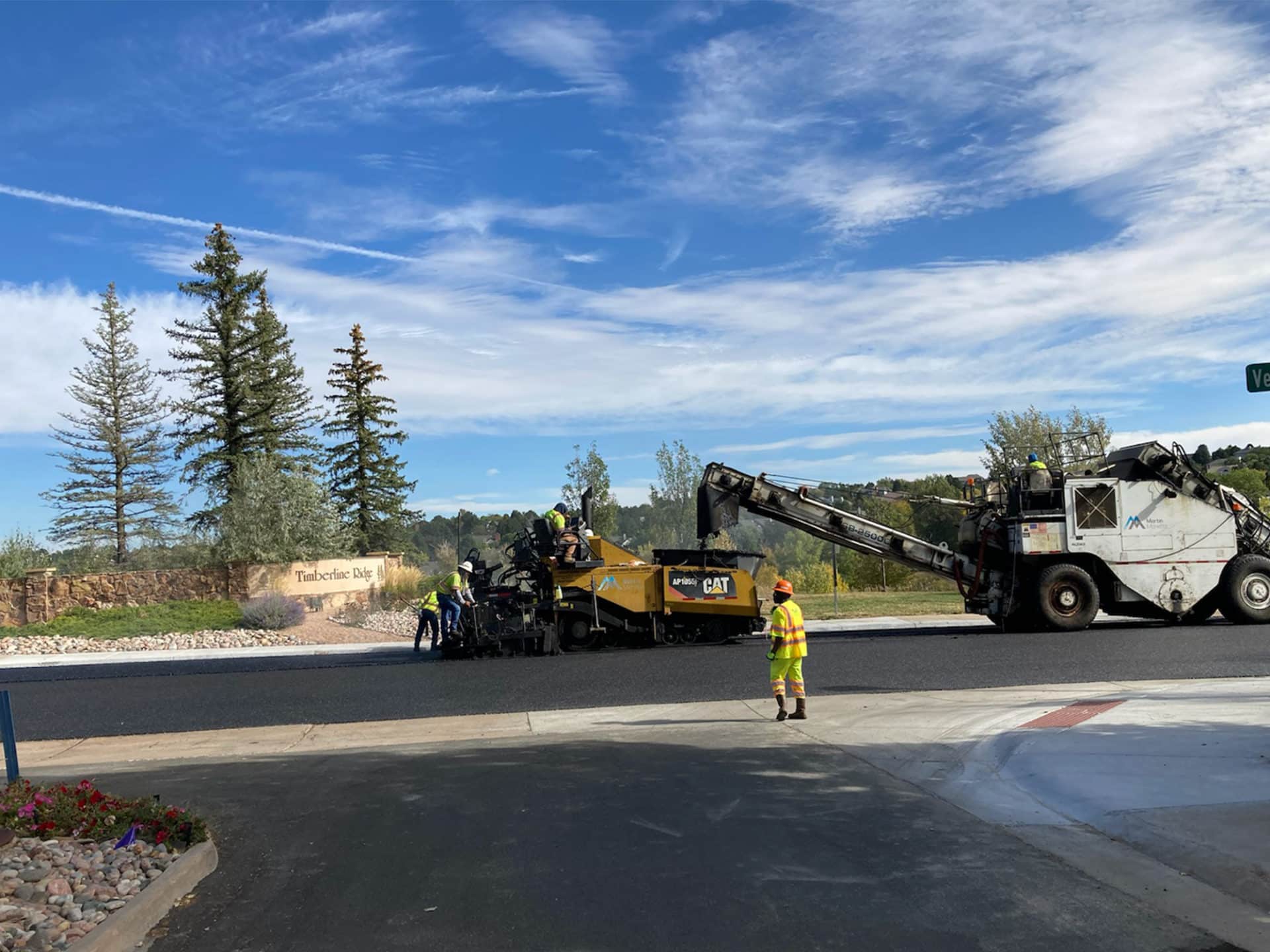

Project Photos
